Sub Contracting Best Practices

This section explains our recommended process for doing Sub Contracting using the MET/TEAM application.

Note: The process described below assumes these Work Order statuses have been added by the System Administrator:

“Send to Sub Contractor”

“Sent to Sub Contractor”

“Returned from Sub Contractor”

1.       On the Type that is associated with the Asset that is being sub contracted, create a Procedure (for example: “Sub Contractor – Fluke”, “Sub Contractor – Agilent”).

2.       Create a Work Order by selecting the Workflow menu Receiving sub menu.

3.       From the Receiving screen complete the receiving details and all information pertaining to this asset. Select the status “Send to Sub Contractor” and then the Process button and the asset will be processed.

4.       After the Process button is selected, the Edit Work Order button is enabled. (Notice the yellow highlighted button in the screen shot above.) Select the Edit Work Order button and the Work Order is opened.

5.       The Work Order is opened.

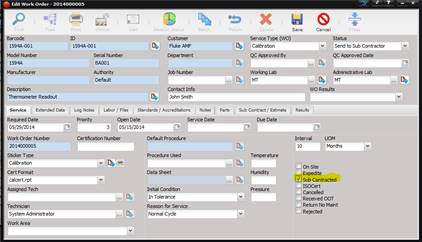

6.       Check the Sub Contractor check box.

7.       Select the Sub Contractor /Estimate tab and the Facility that is the Sub Contractor. The Sub Contractor is selected by pressing the “…” button next to the Sub Contractor field. This Facility must be setup ahead of time. The Find Facility screen is displayed. If the Sub Contractor check box is not selected, select this check box so you are choosing only from the Facilities that have been designated as approved Sub Contractors.

8.       Enter any notes in the Notes field. Notes may include; who the asset was sent to, how the asset was sent (UPS, FedEx), the shipment number or tracking number, any notes related to the process, type of accreditation, possibly expected return date, quote back or fixed price.

9.       Enter the date you expect to receive the instrument back or enter the date the instrument was sent to the Sub Contracting Facility in the Delay Date field

10.   If known, enter the price that you are charging the customer in the Sub Cont Cost field.

11.   Using the Log Notes tab, add a Log Note and change the status to “Sent to Sub Contractor”.

12.   Save the Work Order.

13.   Wait for the return of the asset from the Sub Contractor and update the Notes field on the Sub Contractor / Estimate tab as necessary.

14.   When Asset is returned from the Sub Contractor, open the Work Order and add a Log Note changing the Status to “Returned from Sub Contractor”.

15.   Select the Sub Contractor tab and complete the information:

a.       Sub Cont Cost  – the amount the lab is charging the customer

b.       Sub Cont Lab Cost – the amount the lab paid Sub Contractor

c.       Sub Cont Hours – if you will be tracking internally the hours related to this Sub Contracting event enter them here

16.   Select the Service tab.

a.       Select the Procedure Used if necessary.

b.       The Data Sheet will typically be blank.

c.       Attach the Report returned from Sub Contractor using the Labor/Files tab. This file should be not marked “Private”. Therefore, in Customer Portal, the Customer will be able to view and print the certificate.

d.       If the customer has been invoiced, use the Labor/Files tab and attach the Invoice marking this file as private. This invoice is from the Sub Contractor stating the amount due for the work they performed.

e.       Continue filling in the all information on the Service tab making sure to complete the Service Date and Due Date.

f.        If you are outsourcing your own equipment, the Sub Cont Lab Cost may not be applicable.

17.   Follow your standard metrology practices filling in the data on the remaining tabs. The Notes field on the Notes tab can be utilized for ISO accredited or anything specific to this Asset.

18.   Save the Work Order.

19.   When you are ready to Return the asset, enter a Log Note changing the Status to Complete.

20.   Use the Return button to return the Asset which is now ready for Shipping.

21.   If not already invoiced, follow normal business process to Invoice the customer.
